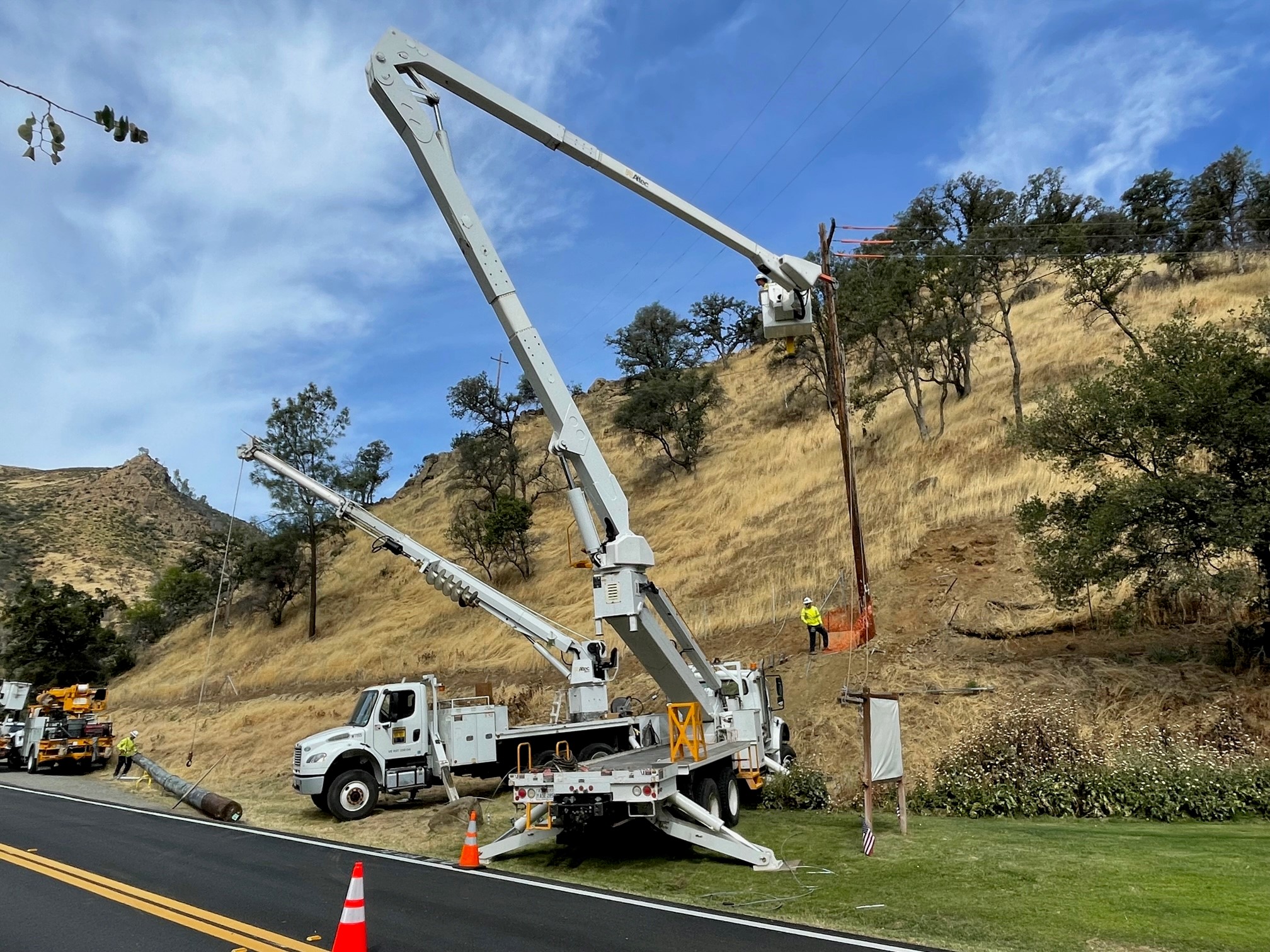

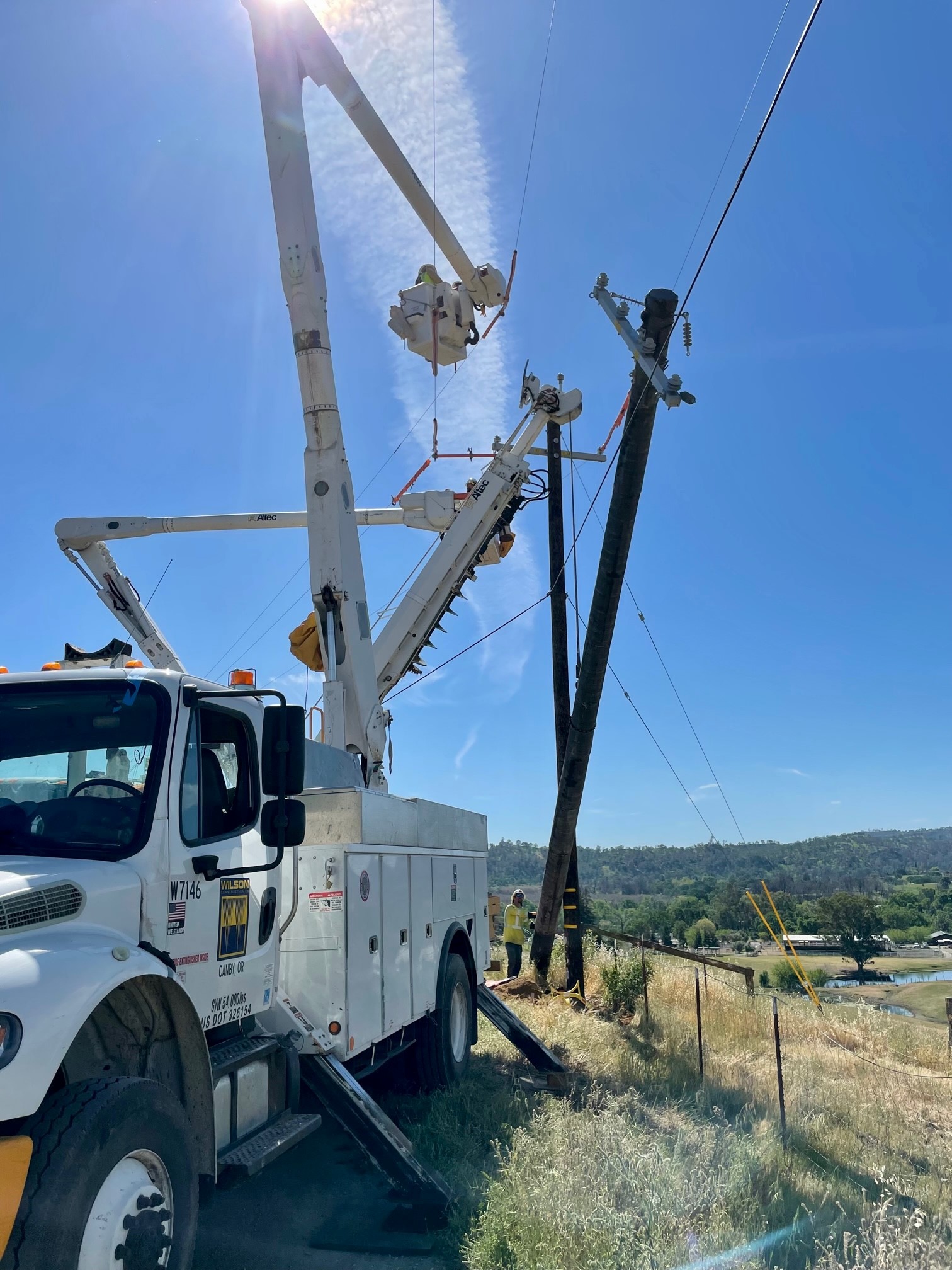

Wilson worked closely with PG&E’s engineering team to construct nearly 30 miles of system hardening, which included more than 400 poles and nearly 150,000 ft of new tree wire conductor. To accommodate PG&E’s request to expedite the project, Wilson crews successfully completed all 30 miles of system hardening in less than four months, from March 2022 to June 2022. To meet the tight scheduling requirements, Wilson had up to eight crews working on this project at once.
View the embedded image gallery online at:
https://wilsonconst.com/services/distribution-construction/item/514-putah-creek#sigProId9e623bf4c7
https://wilsonconst.com/services/distribution-construction/item/514-putah-creek#sigProId9e623bf4c7
In the spring of 2022, Wilson was contracted by Pacific Gas and Electric Company (PG&E) to advance their Wildfire Safety Program and reduce the risk of future wildfire ignitions in PG&E’s service area.
